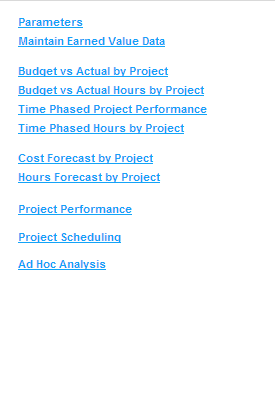

Reports

Infor BI provides various reports to help project managers monitor the overall progress of a project.

[...]
Setting filters for the BI reports


Setting filters for the BI reports

To generate the reports, you must select the following range of data:

  • Currency Type:
    The four types of currencies that you can use to display the data in the reports:
    • Base Currency : A standard or a reference currency used to express the budget data.
    • Project Currency : The default currency of the project. The report is always displayed in project currency.
    • Reporting Currency : The currency used to express the data in the reports.
    • Transaction Currency : The currency used in the transactions.
  • Company
    The range of company codes, for which the report must be generated.
  • Project
    The range of project codes, for which the report must be generated.
  • Status
    The range of the project statuses for which the report must be generated.
  • Contract
    The range of contract codes, for which the report must be generated.
  • Contract Type
    The contract types for which the report must be generated.
  • Status
    The contract status for which the report must be generated.
  • Sold-to Business Partner
    The range of sold-to business partner codes, for which the report must be generated.
  • Contract Manager
    The range of contract manager codes, for which the report must be generated.
  • Invoice Type
    The invoice types, for which the report must be generated.
  • Sales Office
    The range of sales office codes, for which the report must be generated.
  • Group
    The range of groups, for which the report must be generated.
  • Acquiring Method
    The range of the acquiring methods for which the report must be generated.
  • Financing Method
    The range of the financing methods for which the report must be generated.
  • Business Sector
    The range of the business sectors for which the report must be generated.
  • Geographical Area
    The range of the geographical areas for which the report must be generated.
  • Category
    The range of the categories for which the report must be generated.
  • Program
    The range of the programs for which the report must be generated.
  • Project Manager
    The range of project managers for which the report must be generated.
  • Actual Cost

    The options to view the actual costs for which the report must be generated:

    • Actual Cost: Only the actual costs are displayed in the report.
    • Actual Cost + Hard commitment: The sum of the actual costs and hard commitments is displayed.
    • Actual Cost + Hard Commitment + Soft commitment: The sum of the actual costs, hard commitments and soft commitments is displayed.
Note

When you modify this parameter, the data is updated in the BI reports.





Budget vs. Actual


Budget vs. Actual

Budget vs Actual by Project


Budget vs Actual by Project

The Budget vs Actual by Project report displays the actual cost against the available budget for the selected project.

Select the required project and click Budget vs Actual by Project/ Activity to view the report.

To generate the report, specify:

  • Company
    The code of the company.
  • Currency Type
    The type of the currency used for the project.
  • Project
    The code of the project (range) for which the budget report is generated.
  • Status
    The project status.
  • Acquiring Method
    The method used to acquire the project.
  • Financing Method
    The financing method used for the project.
  • Business Sector
    The area of commercial endeavour. Projects can be categorized based on the business sector.
  • Geographical Area
    The geographical area associated with the project.
  • Category
    The user-defined classification of the project.
  • Program
    A group of related projects managed in a coordinated way to obtain more benefits and control.
  • Project Manager
    The employee who manages the project.
  • Actual Cost
    Actual Cost = Actual Cost + Hard Commitment

    or

    Actual Cost = Actual Cost + Hard Commitment + Soft Commitment

The report displays:

  • Project
    The project for which the report is generated.
  • Currency
  • Budget
    The budget allocated to the selected project.
  • Actual Cost
    The actual cost incurred on the project.
  • Balance Budget

    • Amount

      The balance amount calculated using the formula:

      (Budget - Actual Cost)
    • %

      The balance amount expressed as a percentage:

      ((Budget - Actual Cost)/ Budget))*100





Budget vs Actual by Project/ Activity


Budget vs Actual by Project/ Activity

The Budget vs Actual by Project/ Activity report displays the actual cost against the available budget for the project, at the activity level.

Select the required activity and click Budget vs Actual by Project / Activity / Cost Component or Budget vs Actual by Project / Activity / Control Code to view the report for:

  • The budget vs actual data at the project/ activity/ cost component level
  • The budget vs actual data at the project/ activity/ control code level

To generate the report, specify:

  • Company
    The code of the company.
  • Currency Type
    The type of the currency used for the project.
  • Project
    The code of the project for which the report is generated.

The report displays:

  • Activity
    The activity linked to the project.
  • Status
    The status of the budget.
  • Currency
  • Budget
    The budget allocated to the selected project.
  • Actual Cost
    The actual cost incurred on the project.
  • Balance Budget

    • Amount

      The balance amount calculated using the formula:

      (Budget - Actual Cost)
    • %

      The balance amount expressed as a percentage:

      ((Budget - Actual Cost)/ Budget))*100





Budget vs Actual by Project/ Activity/ Cost Component


Budget vs Actual by Project/ Activity/ Cost Component

The Budget vs Actual by Project/ Activity/ Cost Component report displays the actual cost against the available budget for the project, at the cost component level.

To generate the report, specify:

  • Company
    The code of the company.
  • Currency Type
    The type of the currency used for the project.
  • Project
    The code of the project for which the report is generated.
  • Activity
    The activity linked to the project.

The report displays this data:

  • Cost Component
    The cost component linked to the project.
  • Currency
  • Budget
    The budget allocated to the selected project.
  • Actual Cost
    The actual cost incurred on the project.
  • Balance Budget

    • Amount

      The balance amount calculated using the formula:

      (Budget - Actual Cost)
    • %

      The balance amount expressed as a percentage:

      ((Budget - Actual Cost)/ Budget))*100





Budget vs Actual by Project/ Activity/ Control Code


Budget vs Actual by Project/ Activity/ Control Code

The Budget vs Actual by Project/ Activity/ Control Code report displays the actual cost against the available budget for the project, at the control code level.

To generate the report, specify:

  • Company
    The code of the company.
  • Currency Type
    The type of the currency used for the project.
  • Project
    The code of the project for which the report is generated.
  • Activity
    The activity linked to the project.

The report displays this data:

  • Control Code
    The control code linked to the project.
  • Currency
  • Budget
    The budget allocated to the selected project.
  • Actual Cost
    The actual cost incurred on the project.
  • Balance Budget

    • Amount

      The balance amount calculated using the formula:

      (Budget - Actual Cost)
    • %

      The balance amount expressed as a percentage:

      ((Budget - Actual Cost)/ Budget))*100





Budget vs Actual Hours by Project


Budget vs Actual Hours by Project

The Budget vs Actual Hours by Project report displays the planned hours against the actual hours of the project, for the available budget.

Select the required project and click Budget vs Actual Hours by Project/ Activity to view the report.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project (range) for which the report is generated.
  • Status
    The project status.
  • Acquiring Method
    The method used to acquire the project.
  • Financing Method
    The financing method used for the project.
  • Business Sector
    An area of commercial endeavour. Projects can be categorized based on the business sector.
  • Geographical Area
    The geographical area associated with the project.
  • Category
    The user-defined classification of the project.
  • Program
    A group of related projects managed in a coordinated way to obtain more benefits and control.
  • Project Manager
    The employee who manages the project.

The report displays:

  • Project
    The code of the project for which the report is generated.
  • Planned Hours
    The budgeted hours required for the completion of the project.
  • Actual Hours
    The actual hours utilized for the completion of the project.
  • Balance Hours

    The balance hours calculated using the formula:

    (Planned Hours - Actual Hours)
  • Budget %

    The balance amount expressed as a percentage:

    ((Planned Hours - Actual Hours)/ Planned Hours))*100





Budget vs Actual Hours by Project/ Activity


Budget vs Actual Hours by Project/ Activity

The Budget vs Actual Hours by Project/ Activity report displays the planned hours against the actual hours of the project for the available budget at the activity level.

Select the required activity and click Budget vs Actual Hours by Project / Activity / Cost Component or Budget vs Actual Hours by Project / Activity / Control Code level to view the report for:

  • The budget vs actual hours data at project/ activity / cost component level
  • The budget vs actual hours data at project/ activity / control code level

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which budget report must be generated.

The report displays:

  • Activity
    The activity linked to the project.
  • Status
    The status of the budget.
  • Planned Hours
    The budgeted hours required for the completion of the project.
  • Actual Hours
    The actual hours utilized for the completion of the project.
  • Balance Hours

    The balance hours calculated using the formula:

    (Planned Hours - Actual Hours)
  • Budget %

    The balance hours expressed as a percentage:

    ((Planned Hours - Actual Hours)/ Planned Hours))*100





Budget vs Actual Hours by Project/ Activity/ Cost Component


Budget vs Actual Hours by Project/ Activity/ Cost Component

The Budget vs Actual Hours by Project/ Activity/ Cost Component report displays the planned hours against the actual hours of the project for the available budget, at the cost component level.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which the budget report is generated
  • Activity
    The activity linked to the project.

The report displays:

  • Cost Component
    The cost component linked to the project.
  • Planned Hours
    The budgeted hours required for the completion of the project.
  • Actual Hours
    The actual hours utilized for the completion of the project.
  • Balance Hours

    The balance hours calculated using the formula:

    (Planned Hours - Actual Hours)
  • Budget %

    The balance hours expressed as a percentage:

    ((Planned Hours - Actual Hours)/ Planned Hours))*100





Budget vs Actual Hours by Project/ Activity/ Control Code


Budget vs Actual Hours by Project/ Activity/ Control Code

The Budget vs Actual Hours by Project/ Activity/ Control Code report displays the planned hours against the actual hours of the project for the available budget, at the control code level.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which the report is generated
  • Activity
    The activity linked to the project.

The report displays:

  • Control Code
    The control code linked to the project.
  • Planned Hours
    The budgeted hours required for the completion of the project.
  • Actual Hours
    The actual hours utilized for the completion of the project.
  • Balance Hours

    The balance hours calculated using the formula:

    (Planned Hours - Actual Hours)
  • Budget %

    The balance hours expressed as a percentage:

    ((Planned Hours - Actual Hours)/ Planned Hours))*100





Note

In the graphical representation of the budget, the percentage of balance budget amount is indicated using various colours:

  • Blue - [...]: Percentage of the budget used for the project.
  • Yellow - [...]: Percentage of the budget available for the project.
  • Red - [...]: Percentage of the available budget for the project is negative.





Time Phased Performance


Time Phased Performance

Time Phased Project Performance


Time Phased Project Performance

The Time Phased Project performance report allows you to review the time phased budget and the actual cost data of the project for the current and the cumulative periods. Time phasing is based on the Earned Value (EV) method specified for the activity.

Select the required project and click Time Phased Budget vs Actuals by Project/ Activity to view the report.

To generate the report, specify:

  • Currency Type
    The type of the currency used for the project.
  • Company
    The code of the company.
  • Project
    The code of the project (range) for which the report is generated.
  • Status
    The project status.
  • Acquiring Method
    The method used to acquire the project.
  • Financing Method
    The financing method used for the project.
  • Business Sector
    An area of commercial endeavour. Projects can be categorized based on the business sector.
  • Geographical Area
    The geographical area associated with the project.
  • Category
    The user-defined classification of the project.
  • Program
    A group of related projects managed in a coordinated way to obtain more benefits and control.
  • Project Manager
    The employee who manages the project.
  • Actual Cost
    Actual Cost = Actual Cost + Hard Commitment

    or

    Actual Cost = Actual Cost + Hard Commitment + Soft
    		  Commitment

The report displays this data:

  • Project
    The code of the project for which the report is generated.
  • Currency
    The project currency. Note: This value is based on the Currency Type, selected in the settings.
  • Period/ Cumulative

    • Year
      The current/ cumulative year for which report is generated.
    • Period
      The current/ cumulative period of the year for which report is generated.
    • Budget
      The budget allocated to the project in the current/ cumulative period.
    • Actual Cost
      The actual cost incurred on the project in the current/ cumulative period.
    • Balance Budget

      The balance amount in the current/ cumulative period, calculated using the formula:

      (Budget - Actual Cost)
    • Balance Budget %

      The balance amount expressed as a percentage:

      ((Budget - Actual Cost)/ Budget))*100





Time Phased Budget vs Actuals by Project/ Activity


Time Phased Budget vs Actuals by Project/ Activity

The Time Phased Budget vs Actuals by Project/ Activity report displays the time phased budget and actual cost data of the project for the current and the cumulative periods, at the activity level. Time phasing is based on the Earned Value (EV) method specified for the activity.

Select the required activity and click Time Phased Budget vs Actuals by Project/ Activity/ Cost Component report or Time Phased Budget vs Actuals by Project/ Activity/ Control Code to view the report for:

  • The time phased budget vs actual cost data at the project/ activity/ cost component level
  • The time phased budget vs actual cost data at the project/ activity/ control code level

To generate the report, specify:

  • Company
    The code of the company.
  • Currency Type
    The type of the currency based on which the report is generated.
  • Project
    The code of the project for which budget report is generated
  • Period (Monthly)
    The periods of the year (range) for which report is generated.

The report displays this data:

  • Activity (Description)
    The activity linked to the project.
  • Currency
    The project currency. Note: This value is based on the Currency Type, selected in the settings.
  • Period/ Cumulative

    • Year
      The current/ cumulative year for which the report is generated.
    • Period
      The current/ cumulative period of the year for which the report is generated.
    • Budget
      The budget allocated to the project in the current/ cumulative period.
    • Actual Cost
      The actual cost incurred on the project in the current/ cumulative period.
    • Balance Budget

      The balance amount in the current/ cumulative period, calculated using the formula:

      (Budget - Actual Cost)
    • Balance Budget %

      The balance amount expressed as a percentage:

      ((Budget - Actual Cost)/ Budget))*100





Time Phased Budget vs Actuals by Project/ Activity/ Cost Component


Time Phased Budget vs Actuals by Project/ Activity/ Cost Component

The Time Phased Budget vs Actuals by Project/ Activity/ Cost Component report displays the time phased budget data and actual cost data of the project for the current and the cumulative periods, at the cost component level. Time phasing is based on the Earned Value (EV) method defined for the activity.

To generate the report, specify:

  • Company
    The code of the company.
  • Currency Type
    The type of the currency used by the project.
  • Project
    The code of the project for which the report is generated
  • Activity
    The code of the activity linked to the project.
  • Period (Monthly)
    The periods of the year (range) for which report is generated.

The report displays:

  • Cost Component (Description)
    The cost component linked to the project.
  • Currency
    The project currency. Note: This value is based on the Currency Type, selected in the settings.
  • Period/ Cumulative

    • Year
      The current/ cumulative year for which the report is generated.
    • Period
      The current/ cumulative period of the year for which the report is generated.
    • Budget
      The budget allocated to the project in the current/ cumulative period.
    • Actual Cost
      The actual cost incurred on the project in the current/ cumulative period.
    • Balance Budget

      The balance amount in the current/ cumulative period, calculated using the formula:

      (Budget - Actual Cost)
    • Balance Budget %

      The balance amount expressed as a percentage:

      ((Budget - Actual Cost)/ Budget))*100





Time Phased Budget vs Actuals by Project/ Activity/ Control Code


Time Phased Budget vs Actuals by Project/ Activity/ Control Code

The Time Phased Budget vs Actuals by Project/ Activity/ Control Code report displays the time phased budget data and actual cost data of the project for the current and the cumulative periods, at the control code level. Time phasing is based on the Earned Value (EV) method specified for the activity.

To generate the report, specify:

  • Company
    The code of the company.
  • Currency Type
    The type of the currency based on which the report is generated.
  • Project
    The code of the project for which budget report is generated
  • Activity
    The code of the activity linked to the project.
  • Period (Monthly)
    The periods of the year (range) for which report is generated.

The report displays this data:

  • Control Code (Description)
    The control code linked to the project.
  • Currency
    The project currency. Note: This value is based on the Currency Type, selected in the settings.
  • Period/ Cumulative

    • Year
      The current/ cumulative year for which the report is generated.
    • Period
      The current/ cumulative period of the year for which the report is generated.
    • Budget
      The budget allocated to the project in the current/ cumulative period.
    • Actual Cost
      The actual cost incurred on the project in the current/ cumulative period.
    • Balance Budget

      The balance amount in the current/ cumulative period, calculated using the formula:

      (Budget - Actual Cost)
    • Balance Budget %

      The balance amount expressed as a percentage:

      ((Budget - Actual Cost)/ Budget))*100





Time Phased Hours by Project


Time Phased Hours by Project

The Time Phased performance report allows you to review the time phased budget data and the actual hours utilized for the project in the current and the cumulative periods. Time phasing is based on the Earned Value (EV) method, specified for the activity.

Select the required project and click Time Phased Hours by Project/ Activity to view the report.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project (range) for which the report is generated.
  • Status
    The project status.
  • Acquiring Method
    The method used to acquire the project.
  • Financing Method
    The financing method used for the project.
  • Business Sector
    The section of economy related to business and corporate organizations. Projects can be categorized based on the business sector.
  • Geographical Area
    The geographical area associated with the project.
  • Category
    The user-defined classification of the project.
  • Program
    A group of related projects managed in a coordinated way to obtain more benefits and control.
  • Project Manager
    The employee who manages the project.

The report displays:

  • Project
    The code of the project for which the report is generated.
  • Period/ Cumulative

    • Year
      The current/ cumulative year for which the report is generated.
    • Period
      The current/ cumulative period of the year for which the report is generated.
    • Planned Hours
      The estimated number of hours required for the completion of the project in the current/ cumulative period. Calculations are based on the Earned Value (EV) method, defined on the activity.
    • Actual Hours
      The actual hours used to complete the project in the current/ cumulative period.
    • Balance Hours

      The balance hours in the current/ cumulative period, calculated using the formula:

      (Planned Hours - Actual Hours)
    • Balance Hours %

      The balance hours expressed as a percentage:

      ((Planned Hours - Actual Hours)/ Planned Hours))*100





Time Phased Hours by Project/ Activity


Time Phased Hours by Project/ Activity

The Time Phased Hours by Project/ Activity report displays the time phased budget data and the actual hours utilized for the project in the current and the cumulative periods at the activity level. Time phasing is based on the Earned Value (EV) method, defined for the activity.

Select the required activity and click Time Phased Hours by Project/ Activity/ Cost Component or Time Phased Hours by Project/ Activity/ Control Code to view the report for:

  • The time phased budget data and the actual hours utilized for the project in the current and the cumulative periods at the project/ activity/ cost component level
  • The time phased budget data and the actual hours utilized for the project in the current and cumulative periods at the project/ activity/ control code level

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which the report is generated

The report displays:

  • Activity (Description)
    The activity linked to the project.
  • Period/ Cumulative

    • Year
      The current/ cumulative year for which the report is generated.
    • Period
      The current/ cumulative period of the year for which the report is generated.
    • Planned Hours
      The estimated number of hours required for the completion of the project in the current/ cumulative period. Calculations are based on the Earned Value (EV) method, defined on the activity.
    • Actual Hours
      The actual hours used to complete the project in the current/ cumulative period.
    • Balance Hours

      The balance hours in the current/ cumulative period, calculated using the formula:

      (Planned Hours - Actual Hours)
    • Balance Hours %

      The balance hours expressed as a percentage:

      ((Planned Hours - Actual Hours)/ Planned Hours))*100





Time Phased Hours by Project/ Activity/ Cost Component


Time Phased Hours by Project/ Activity/ Cost Component

The Time Phased Hours by Project/ Activity/ Cost Component report displays the time phased budget data and the actual hours utilized for the project in the current and the cumulative periods, at the cost component level. Time phasing is based on the Earned Value (EV) method, specified for the activity.

Note

At the cost component level and the control code level, the time phased hours report is displayed only for the cost type; Labor.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which the report is generated.
  • Activity (Description)
    The activity linked to the project.

The report displays:

  • Cost Component (Description)
    The cost component linked to the project.
  • Period/ Cumulative

    • Year
      The current/ cumulative year for which the report is generated.
    • Period
      The current/ cumulative period of the year for which the report is generated.
    • Planned Hours
      The estimated number of hours required for the completion of the project in the current/ cumulative period. Calculations are based on the Earned Value (EV) method, defined on the activity.
    • Actual Hours
      The actual hours used to complete the project in the current/ cumulative period.
    • Balance Hours

      The balance hours in the current/ cumulative period, calculated using the formula:

      (Planned Hours - Actual Hours)
    • Balance Hours %

      The balance hours expressed as a percentage:

      ((Planned Hours - Actual Hours))/ Planned Hours))*100





Time Phased Hours by Project/ Activity/ Control Code


Time Phased Hours by Project/ Activity/ Control Code

The Time Phased Hours by Project/ Activity/ Control Code report displays the time phased budget data and the actual hours utilized for the project in the current and the cumulative periods, at the control code level. Time phasing is based on the Earned Value (EV) method, specified for the activity.

Note

At the cost component level and the control code level, the time phased hours report is displayed only for the cost type; Labor.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which the report is generated
  • Activity (Description)
    The activity linked to the project.

The report displays:

  • Control Code (Description)
    The control code linked to the project.
  • Period/ Cumulative

    • Year
      The current/ cumulative year for which the report is generated.
    • Period
      The current/ cumulative period of the year for which the report is generated.
    • Planned Hours
      The estimated number of hours required for the completion of the project in the current/ cumulative period. Calculations are based on the Earned Value (EV) method, defined on the activity.
    • Actual Hours
      The actual hours used to complete the project in the current/ cumulative period.
    • Balance Hours

      The balance hours in the current/ cumulative period, calculated using the formula:

      (Planned Hours - Actual Hours)
    • Balance Hours %

      The balance hours expressed as a percentage:

      ((Planned Hours - Actual Hours)/ Planned Hours))*100










Cost Forecast


Cost Forecast

Cost Forecast by Project


Cost Forecast by Project

The Cost Forecast report allows the project manager to analyze the expected future costs, the total cost required to complete the project and determine the budget variance.

Select the required project to view the forecast data of the project at the activity level.

To generate the report, specify:

  • Currency Type
    The type of the currency based on which the report is generated.
  • Company
    The code of the company.
  • Project
    The project (range) for which the report is generated.
  • Status
    The project status.
  • Acquiring Method
    The method used to acquire the project.
  • Financing Method
    The financing method used for the project.
  • Business Sector
    The section of economy related to business and corporate organizations. Projects can be categorized based on the business sector.
  • Geographical Area
    The geographical area associated with the project.
  • Category
    The user-defined classification of the projects.
  • Program
    A group of related projects managed in a coordinated way to obtain more benefits and control.
  • Project Manager
    The employee who manages the project.

The report displays this data:

  • Budget
    The budget data is based on the last approved version in the BI.
  • Actual Cost
    The cost data is populated from Infor LN
  • Progress
    The project progress data is populated from Infor LN.
  • Forecast

    • Estimate To Complete (ETC)

      Estimate To Complete is the additional cost incurred for an activity or a project.

      Estimate To Complete = Estimate At Completion - Actual Cost
    • Estimate At Completion (EAC)

      Estimate At Completion is the total cost incurred for an activity or a project.

    • Variance At Completion (VAC)

      Variance At Completion is the difference between the budgeted amount and the estimated amount at the end of the project.

      Variance At Completion = Budget - Estimate At Completion





Cost Forecast by Project/ Activity


Cost Forecast by Project/ Activity

The Cost Forecast by Project/ Activity report allows the project manager to analyze the expected future costs, the total cost required to complete the project and determine the budget variance, at the activity level.

Select the required activity to view the forecast data of the project at the project/ activity/ control code level.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The project (range) for which budget report is generated.
  • Currency Type
    The type of the currency based on which the report is generated.

The report displays this data:

  • Activity (Description)
    The activity linked to the project.
  • Progress %
    The project progress data populated from Infor LN.
  • Currency
    The currency used to display the data in the report. Note: This value is based on the selected Currency Type.
  • Budget
    The budget data is based on the last approved version in the BI.
  • Actual Cost
    The cost data is populated from Infor LN
  • Forecast

    • Estimate To Complete (ETC)

      Estimate To Complete is the additional cost incurred for an activity or a project.

      Estimate To Complete = Estimate At Completion - Actual Cost
    • Estimate At Completion (EAC)

      Estimate At Completion is the total cost incurred for an activity or a project.

    • Variance At Completion (VAC)

      Variance At Completion is the difference between the budgeted amount and the estimated amount at the end of the project.

      Variance At Completion = Budget - Estimate At Completion





Cost Forecast by Project/ Activity/ Control Code


Cost Forecast by Project/ Activity/ Control Code

The Cost Forecast by Project/ Activity/ Control Code report allows the project manager to analyze the expected future costs, the total cost required to complete the project and determine the budget variance, at the control code level.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The project (range) for which budget report is generated.
  • Activity (Description)
    The activity linked to the project.
  • Currency Type
    The type of the currency used to display the data in the report.

The report displays this data:

  • Control Code (Description)
    The control code linked to the project.
  • Currency
    The currency used to display the data in the report. Note: This value is based on the selected Currency Type.
  • Budget
    The budget data is based on the last approved version in the BI.
  • Actual Cost
    The cost data is populated from Infor LN.
  • Forecast

    • Estimate To Complete (ETC)

      Estimate To Complete is the additional cost incurred for an activity or a project.

      Estimate To Complete = Estimate At Completion - Actual Cost
    • Estimate At Completion (EAC)

      Estimate At Completion is the total cost incurred for an activity or a project.

    • Variance At Completion (VAC)

      Variance At Completion is the difference between the budgeted amount and the estimated amount at the end of the project.

      Variance At Completion = Budget - Estimate At Completion





Hours Forecast by Project


Hours Forecast by Project

The Hours Forecast by Project report allows the project manager to analyze the planned hours, the actual hours utilized to complete the project and determine the variance, for the specified range of data.

Select the required project to view the hours forecast data of the project at the activity level.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which the report is generated.
  • Status
    The project status.
  • Acquiring Method
    The method used to acquire the project.
  • Financing Method
    The financing method used for the project.
  • Business Sector
    An area of commercial endeavor. Projects can be categorized based on the business sector.
  • Geographical Area
    The geographical area associated with the project.
  • Category
    The user-defined classification of the project.
  • Program
    A group of related projects managed in a coordinated way to obtain more benefits and control.
  • Project Manager
    The employee who manages the project.

The report displays:

  • Project
    The project for which the forecast report is generated.
  • Planned Hours
    The budgeted number of hours required for the completion of the project.
  • Actual Hours
    The actual number of hours utilized to complete the project.
  • Forecast

    • Estimate To Complete (ETC)

      Estimate To Complete is the additional cost incurred for an activity or a project.

      Estimate To Complete = Estimate At Completion - Actual Hours
    • Estimate At Completion (EAC)

      Estimate At Completion is the total cost incurred for an activity or a project.

    • Variance At Completion (VAC)

      Variance At Completion is the difference between the budgeted hours and the estimated hours, at the completion of the project.

      Variance At Completion = Planned Hours - Estimate At Completion





Hours Forecast by Project/ Activity


Hours Forecast by Project/ Activity

The Hours Forecast by Project/ Activity report helps the project manager to analyze the planned hours, the actual hours utilized to complete the project and determine the variance; at the activity level.

Select the required activity to view the hours forecast data of the project at the project/ activity/ control code level.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which the report is generated.

The report displays:

  • Activity (Description)
    The activity linked to the project.
  • Progress %
    The project progress data populated from LN.
  • Planned Hours
    The budgeted number of hours required for the completion of the project.
  • Actual Hours
    The actual number of hours utilized to complete the project.
  • Forecast

    • Estimate To Complete (ETC)

      Estimate To Complete is the additional cost incurred for an activity or a project.

      Estimate To Complete = Estimate At Completion - Actual Hours
    • Estimate At Completion (EAC)

      Estimate At Completion is the total cost incurred for an activity or a project.

    • Variance At Completion (VAC)

      Variance At Completion is the difference between the budgeted hours and the estimated hours, at the completion of the project.

      Variance At Completion = Planned Hours - Estimate At Completion





Hours Forecast by Project/ Activity/ Control Code


Hours Forecast by Project/ Activity/ Control Code

The Hours Forecast by Project/ Activity/ Control Code report allows the project manager to analyze the planned hours, the actual hours utilized to complete the project and determine the variance; at the control code level.

Note

The hours forecast report at the control code level is displayed only for the cost type, Labor.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which the report is generated.
  • Activity (Description)
    The activity linked to the project.

The report displays:

  • Control Code (Description)
    The control code linked to the project.
  • Planned Hours
    The estimated number of hours required for the completion of the project.
  • Actual Hours
    The actual number of hours utilized to complete the project.
  • Forecast

    • Estimate To Complete (ETC)

      Estimate To Complete is the additional cost incurred for an activity or a project.

      Estimate To Complete = Estimate At Completion - Actual Hours
    • Estimate At Completion (EAC)

      Estimate At Completion is the total cost incurred for an activity or a project.

    • Variance At Completion (VAC)

      Variance At Completion is the difference between the budgeted hours and the estimated hours, at the completion of the project.

      Variance At Completion = Planned Hours - Estimate At Completion










Earned Value Management


Earned Value Management

Project Performance


Project Performance

The Project Performance report allows you to review the performance indices of the project. These are calculated using the earned value and the variance data for the current and cumulative periods.

Select the required project and click Project Performance by Project/ Activity or Project Performance by Project/ OBS to view the report for:

To generate the report, specify:

  • Currency Type
    The type of the currency used to display the data in the reports.
  • Company
    The code of the company.
  • Project
    The code of the project for which the report is generated.
  • Status
    The project status.
  • Acquiring Method
    The method used to acquire the project.
  • Financing Method
    The financing method used for the project.
  • Business Sector
    The section of economy related to business and corporate organizations. Projects can be categorized based on the business sector.
  • Geographical Area
    The geographical area associated with the project.
  • Category
    The user-defined classification of the project.
  • Program
    A group of related projects managed in a coordinated way to obtain more benefits and control.
  • Project Manager
    The employee who manages the project.
  • Actual Cost
    Actual Cost = Actual Cost + Hard Commitment

    or

    Actual Cost = Actual Cost + Hard Commitment + Soft Commitment

The report displays this data:

  • Project
    The code of the project for which the report is generated.
  • Currency
    The currency in which the report data is displayed. Note: This value is based on the selected Currency Type.
  • Period/ Cumulative

    • Year
      The current/ cumulative year for which the report is generated.
    • Period
      The current/ cumulative period of the year for which the report is generated.
    • Planned Value
      The amount of work planned in the current/ cumulative period.
    • Earned Value
      The amount of work completed in the current/ cumulative period.
    • Actuals
      The actual cost incurred for the task in the current/ cumulative period.
    • Cost variance

      The difference between the estimated cost and the actual cost incurred for the task.

      Cost variance = Earned value - Actual
      				costs
    • The time period by which a project is ahead of or behind the schedule.

      Schedule variance = Earned value – Planned
      				value
  • The index is calculated by dividing earned value with actual cost.
  • The index is calculated by dividing earned value with planned value.
EV Method in Infor LNEV calculation is based on
Percent CompleteProgress defined in Infor LN for the activity
Start and End PercentStart and end date of the activity
MilestoneMilestone completion date
Level of EffortEffort to complete the project
ApportionedDistribution of the Earned value







Project Performance by Project/ Activity


Project Performance by Project/ Activity

The Project Performance by Project/ Activity report displays the performance indices. These are calculated using the earned value and variance data of the project for the current and cumulative periods, at the activity level.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which the report is generated.
  • Currency Type
    The type of the currency based on which the report is generated.
  • Period (Monthly)
    The period (range) of the year for which the report is generated.

The Project Performance report displays this data:

  • Activity (Description)
    The activity linked to the project.
  • Currency
    The currency in which the report data is displayed. Note: This value is based on the selected Currency Type.
  • Period/ Cumulative

    • Year
      The current/ cumulative year for which the report is generated.
    • Period
      The current/ cumulative period of the year for which the report is generated.
    • Planned Value
      The amount of work planned in the current/ cumulative period.
    • Earned Value
      The amount of work completed in the current/ cumulative period.
    • Actuals
      The actual cost incurred for the task in the current/ cumulative period.
    • Cost variance

      The difference between the estimated cost and the actual cost incurred for the task.

      Cost variance = Earned value - Actuals
    • Schedule variance

      The time period by which a project is ahead of or behind the schedule.

      Schedule variance = Earned Value - Planned Value
  • Cost Performance Index
    The cost performance index is calculated by dividing earned value with actual cost.
  • Schedule Performance Index
    The schedule performance index is calculated by dividing earned value with planned value.
EV Method in Infor LNEV calculation is based on
Percent CompleteProgress defined in Infor LN for the activity
Start and End PercentStart and end date of the activity
MilestoneMilestone completion date
Level of EffortEffort to complete the project
ApportionedDistribution of the Earned value







Project Performance by Project/ OBS


Project Performance by Project/ OBS

The Project Performance by Project/ OBS report displays the performance indices of the project. These are calculated using the earned value and the variance data of the project for the current and cumulative periods, at the organization breakdown structure (OBS) level.

To generate the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which the report is generated.
  • Currency Type
    The type of the currency used to display the data in the reports.
  • Period (Monthly)
    The period (range) of the year for which the report is generated.

The report displays this data:

  • OBS (Description)
    The organization breakdown structure (OBS) linked to the project.
  • Currency
    The currency in which the report data is displayed. Note: This value is based on the selected Currency Type.
  • Period/ Cumulative

    • Year
      The current/ cumulative year for which the report is generated.
    • Period
      The current/ cumulative period of the year for which the report is generated.
    • Planned Value
      The amount of work planned in the current/ cumulative period.
    • Earned Value
      The amount of work completed in the current/ cumulative period.
    • Actuals
      The actual cost incurred for the task in the current/ cumulative period.
    • Cost variance

      The difference between the estimated cost and the actual cost incurred for the task.

      Cost variance = Earned value - Actuals
    • Schedule variance

      The time period by which a project is ahead of or behind the schedule.

      Schedule variance = Earned Value - Planned Value
  • Cost Performance Index
    The index is calculated by dividing the earned value with actual cost.
  • The index is calculated by dividing the earned value with planned value.
EV Method in Infor LNEV calculation is based on
Percent CompleteProgress defined in Infor LN for the activity
Start and End PercentStart and end date of the activity
MilestoneMilestone completion date
Level of EffortEffort to complete the project
ApportionedDistribution of the Earned value












Project Scheduling


Project Scheduling

The project schedule status allows the project manager to track the project schedule and identify variances for the project, if any. The report allows you to review the project performance with respect to the schedule adherence.

To view the report, specify:

  • Company
    The code of the company.
  • Project
    The code of the project for which the report is generated.
  • Baseline ID
    The ID of approved project baseline.
  • Baseline Execution Index
    A measure of baseline execution of the project.
  • Milestone Execution Index
    A measure of milestone execution of the project.

The report displays this data:

  • Activity (Description)
    The activity linked to the project.
  • Type
    The type of activity.
  • Duration (Days)
    The duration of the activity in the project.
  • Base Line Start Date
    The start date of the activity, as specified in the baseline.
  • Base Line Finish Date
    The end date of the activity, as specified in the baseline.
  • Actual Start Date
    The date when the activity is started.
  • Expected Finish Date
    The date when the activity is expected to finish. This date is the Scheduled Finish Date populated from Infor LN.
  • Actual Finish Date
    The date when the activity is completed.
  • Start Variance

    The number of days by which the activity starts prior to or later than the planned date.

    Start Variance = Baseline Start Date - Actual Start Date
  • Finish Variance

    The number of days by which the activity is expected to finish prior to or later than the planned date.

    Finish Variance = Baseline Finish Date - Expected Finish Date





Ad hoc Analysis


Ad hoc Analysis

The Ad hoc analysis report allows you to review the expected, actual and balance budget data for a specific project.

Note

To review these reports, adhering to the pre-defined sequence is not mandatory.

To view the report, specify:

  • Currency_Type
    The type of the currency based on which the budget data is analyzed.
  • Control_Code
    The control code linked to the project.
  • Cost_Component
    The cost component linked to the project.
  • Project
    The code of the project that must be analyzed.
  • Activity
    The activity linked to the project.
  • OBS
    The organization breakdown structure (OBS) linked to the project.
  • Actual Cost
    Actual Cost = Actual Cost + Hard Commitment

    or

    Actual Cost = Actual Cost + Hard Commitment + Soft Commitment

The Ad-Hoc Analysis report displays this data:

  • Company
    The code of the company.
  • Currency
  • Budget
    The budget allocated to the project.
  • Actuals
    The actual cost incurred on the project.
  • Balance Budget

    The balance amount of the budget calculated using the formula:

    Balance Budget = Budget - Actuals
